Assignments – who is working on projects

While you are creating a new project, you can tell Twproject “who is working on this project” by creating one or more “assignments”

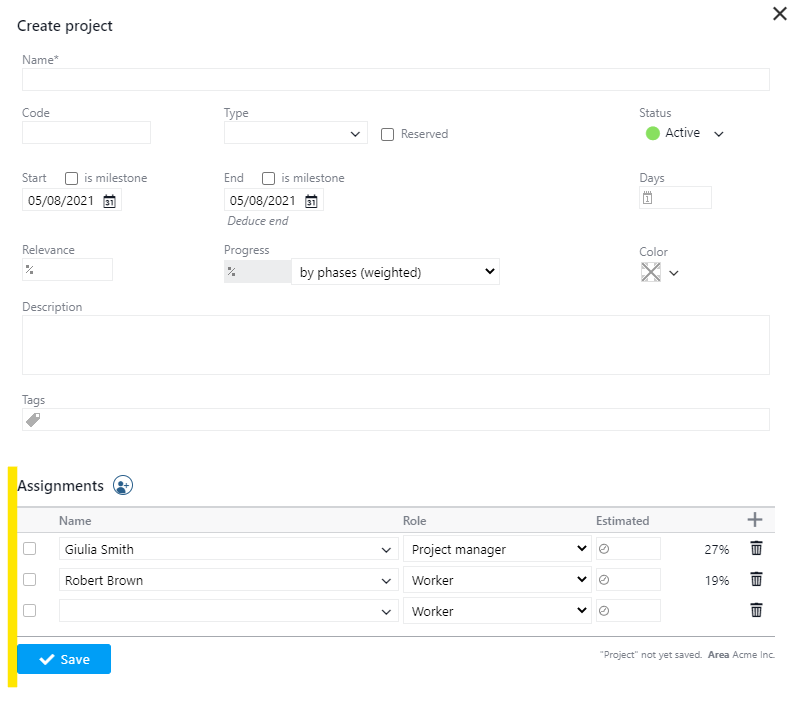

ScreenShot001

Choose the resource, the role played (project manager, customer, worker etc.) and if you already know, an estimated effort in hours.

Twproject will tell you the work load of the resource chosen, to ovoid resource overloading.

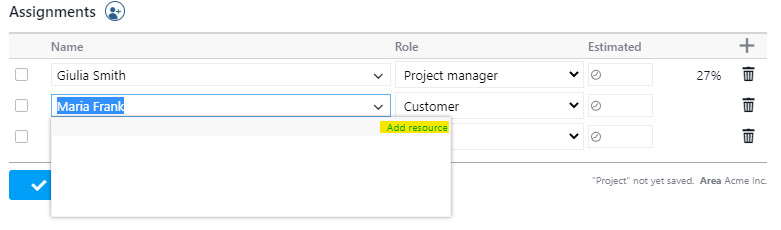

If your resources are not in Twproject already, you can create new ones directly, by clicking on “add resource”:

ScreenShot002

Assignments in Twproject are very important: when you assign a resource you will also implicitly define security settings of the task. In fact every assignment is “weighted” by a “local role” that gives permissions to the assignee. Permissions are, by default, propagated to descendants, so if you are PM on the root you have PM permissions everywhere, but if you are assigned on a child you can act on the child, not on the parent. This makes Twproject security very fine-grained, without the stress of managing permissions separately.

Some basic roles are created during setup, but you can define new ones from the administration page.

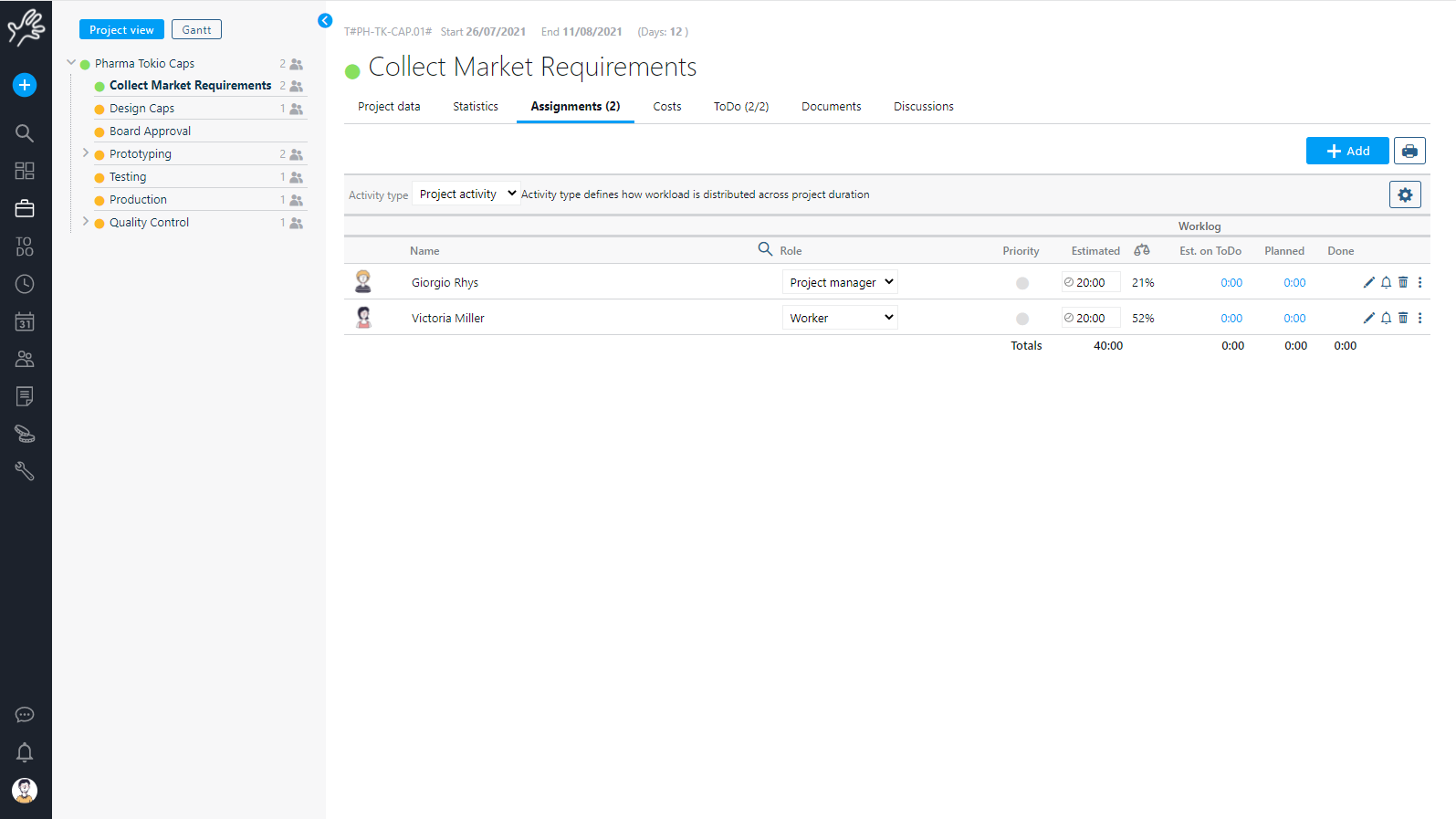

Once the assignments are created you can see the list from the project editor:

ScreenShot003

From the list you can change priority, effort estimations or hourly costs, as well as access to a menu of common actions:

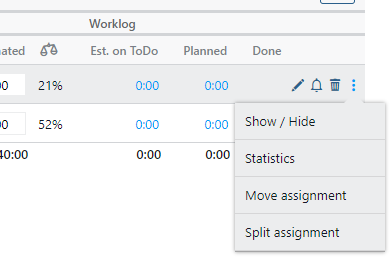

screen1171
Eventually you can add more information to the assignment using the full editor:

screen1170

Then you can describe the activity, assign a priority, specify an hourly cost and a cost center.

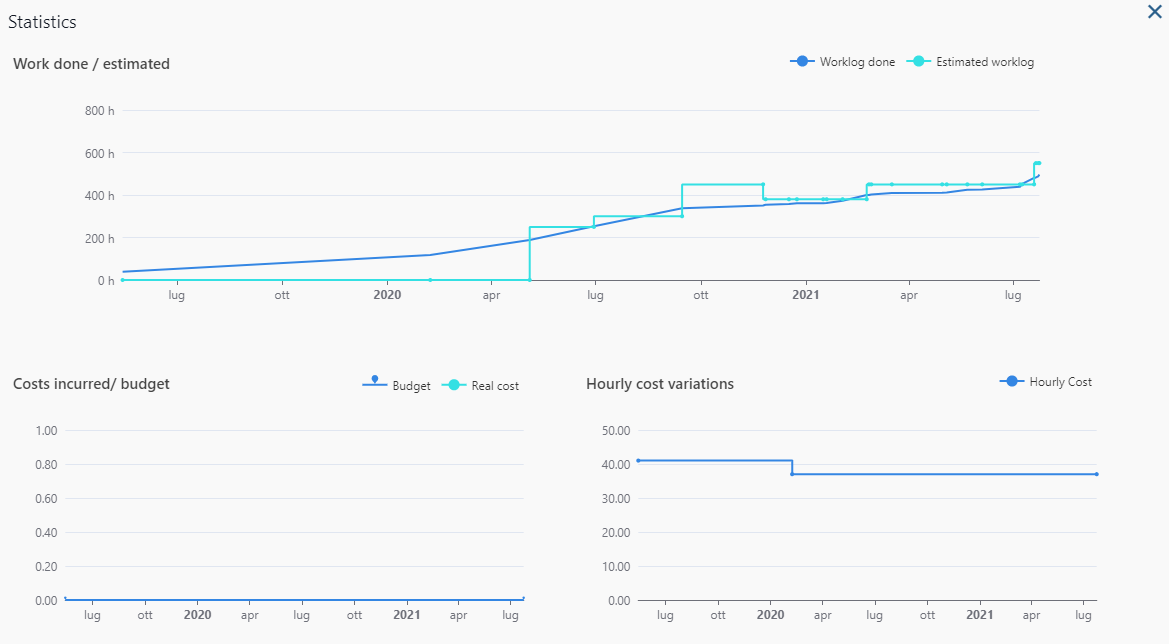

Regarding the estimation of required work, the assignment is the place where it is mostly done; it allows a very fine grained and practical estimation entry point. Notice that directly from this editor you can check the current load of the assignee and check the planned work if you are using that module.

Load by issues: effective when working in an “agile” environment, and in general by issues (see chapter 4 Issues).Click on the link to see issues on which work has been estimated.

There are three more fields that require some explanation:

Activity: could be “all in one interval” or “routine”. Routine activities can be recorded in Twproject without interfering with the “all-in-one-interval” main ones that usually have more focus and relevance.

Enabled: in some cases a resource can have long-standing task assigned that don’t require activity for a long time. In this case you can disable the assignment (the only effect is that it will be hidden in your working pages like home page, timesheets or “my tasks”).

Risk: this is the risk percentage assigned to the resource relatively to this task. This is used mainly when the assignee is at least in some sense a stakeholder, and you have more than one that are sharing the risk.

Budget: is an amount of money dedicated to the resource for expenses on this task. This budget is part of the project’one.

Hourly cost:  hourly cost for the chosen resource on this assignment. By default is the value taken from the resource hourly cost editor if set. Global defaults otherwise.

The hourly rate is copied into the assignment at creation, but if you update the general price of the resource, the already existing assignments will intentionally not be updated, as you may have set that price as an exception. Our idea is that the same resource may have different costs on different assignments, as it is often the case in the real world.

Assignment menu

Expenses: on every assignment you can insert specific “expenses” and a budget. Expenses can be inserted both from the assignment editor and also from worklog week page.

ScreenShot027

Split assignment: open a tool to split the unused hours to a different resource. This tool is used specially when you create projects without knowing how will work on, but you want to specify efforts.

Edit resource: bring to the resource editor

Send a message: open the message editor to send a message to the resource

Operator load: bring to the operator load page for the resource

Plan: bring to the work plan of the resource

Enable/Disable: see above

Delete: will delete the assignment:screen1173

Move assignment

The assignment concept makes Twproject an extremely flexible tool, so when restructuring project trees you can also move single assignments:

screen1176

All data linked to the assignment will “follow” it e.g. worklogs, estimations, expenses, subscriptions. Issues are linked to resource / task so they will not follow – use bulk issue move to move those too..
